Balancing and Settlement Code

BSC PROCEDURE

OVERVIEW OF TRADING ARRANGEMENTS

BSCP01

Version 26.0

Date: 07 November 2024

BSC Procedure 01

relating to

OVERVIEW OF TRADING ARRANGEMENTS

1. Reference is made to the Balancing and Settlement Code and, in particular, to the definition of “BSC Procedure” in Section X, Annex X-1 thereof.

2. This is BSC Procedure 01, Version 26.0 relating to Overview of Trading Arrangements.

3. This BSC Procedure is effective from07 November 2024.

4. This BSC Procedure has been approved by the Panel.

Intellectual Property Rights, Copyright and Disclaimer

The copyright and other intellectual property rights in this document are vested in Elexon or appear with the consent of the copyright owner. These materials are made available for you for the purposes of your participation in the electricity industry. If you have an interest in the electricity industry, you may view, download, copy, distribute, modify, transmit, publish, sell or create derivative works (in whatever format) from this document or in other cases use for personal academic or other non-commercial purposes. All copyright and other proprietary notices contained in the document must be retained on any copy you make.

All other rights of the copyright owner not expressly dealt with above are reserved.

No representation, warranty or guarantee is made that the information in this document is accurate or complete. While care is taken in the collection and provision of this information, Elexon Limited shall not be liable for any errors, omissions, misstatements or mistakes in any information or damages resulting from the use of this information or action taken in reliance on it.

1 Introduction

1.1 Purpose and Scope of the Procedure

This overview describes the component activities of the Trading Arrangements detailed in the Code, from submission of trading data prior to Gate Closure through to final exchange of funds up to fourteen months later. This is in the form of a set of overview process diagrams and a schedule of trading activities (i.e., the Settlement process timetable).

As this document is an overview, process details relating to validation and handling of errors at interfaces are excluded from the process diagrams and schedules. The actions taken by the Settlement Administration Agent in the event of missing or invalid data are described in Appendices 5.1 and 5.2.

1.2 Main Users of the Procedure and their Responsibilities

The main users of this procedure are:

(a) Party Agents

(b) Parties

(c) The Central Registration Agent (CRA)

(d) The Energy Contract Volume Aggregation Agent (ECVAA)

(e) The Balancing Mechanism Reporting Agent (BMRA)

(f) The Central Data Collection Agent (CDCA)

(g) The Settlement Administration Agent (SAA)

(h) The Funds Administration Agent (FAA)

(i) The Supplier Volume Allocation Agent (SVAA)

(j) The Dispute Administrator (DA)

(k) The Teleswitch Agent

(l) Supplier Agents

(m) Market Index Data Providers

(n) The NETSO

All of the above Parties have a responsibility for fulfilling their obligations under the Code, either directly or via other contractual arrangements with signatories to the Code, in respect of ensuring adherence to the Settlement process timetable.

1.3 Key Milestones

The key milestones in this procedure are defined as follows:

(a) Interim Information and Initial Settlement (Section 4.1)

(b) Reconciliation and Final Settlement (Section 4.2)

1.4 Balancing and Settlement Code Provision

This BSCP should be read in conjunction with the Code. This BSCP has been produced in accordance with the provisions of the Code. In the event of an inconsistency between the provisions of this BSCP and the Code, the provisions of the Code shall prevail.

1.5 Associated BSC Procedures

The following is a list of BSCPs covering activities and interfaces that are dependent on the Settlement timetable:

BSCP03

Data estimation and substitution for CVA

BSCP04

BM Unit Metered Volumes for Interconnector Users

BSCP11

Trading Disputes

BSCP65

Registration of BSC Parties and Exit Procedures

BSCP68

Transfer of Registration of metering systems between CMRS and SMRS

BSCP71

Submission of ECVNs and MVRNs

BSCP301

Clearing, Invoicing and Payment

BSCP501

Supplier Meter Registration Service

BSCP502

Half Hourly Data Collection for Metering Systems Registered in SMRS

BSCP503

Half Hourly Data Aggregation for Metering Systems Registered in SMRS

BSCP504

Non Half Hourly Data Collection for Metering Systems Registered in SMRS

BSCP505

Non Half Hourly Data Aggregation for Metering Systems Registered in SMRS

BSCP508

Supplier Volume Allocation Agent

BSCP602

SVA Metering System & Asset Metering System Register

BSCP603

Meter Operations and Data Collection for Asset Metering Systems

1.6 Overview of Trading Arrangements and Settlement Process

1.6.1 Introduction

The Code sets out the obligations with which all Parties must comply and details the arrangements for participation in the balancing mechanism and the Settlement of balancing mechanism transactions and imbalances in Great Britain.

Seasonal Transmission Loss Factors (TLFs) in respect of a BSC Year will be derived and published on the Elexon Portal by no later than 31 December in the preceding BSC Year. Seasonal TLFs will be loaded into CRA no later than 5 WD before the start of the relevant BSC Season. SAA will access Seasonal TLFs for a Settlement Day via the shared SAA/CRA/CDCA database. Consequently Seasonal TLFs are not referenced in Section 4, Interface and Timetable Information.

It is expected that Trading Parties will enter into bilateral contracts in advance of the Submission Deadline (the notification deadline for the purposes of submitting Energy Contract Volume and Meter Volume Reallocation Notifications for each Settlement Period as defined in Annex X-1). These bilateral contract volumes must be notified to the ECVAA no later than the Submission Deadline for the relevant Settlement Period if they are to be taken into account for the purposes of calculating energy imbalances for that Settlement Period, but may be submitted at any time in advance of the Submission Deadline for the relevant Settlement Period.

Prior to Gate Closure, some Lead Parties of BM Units must submit (and some Lead Parties of BM Units may choose to submit) a Final Physical Notification (FPN) to the National Electricity Transmission System Operator (NETSO). This is a minute by minute profile of the expected power output or consumption of the relevant generation or demand across each Settlement Period.

Lead Parties of BM Units may choose to participate in the Balancing Mechanism, i.e. provide balancing services actions for a particular Settlement Period. This willingness to operate at a level other than their FPN is demonstrated with the use of Balancing Mechanism Bids and Offers. An Offer indicates a willingness to increase the level of generation or reduce the level of demand. A Bid indicates a willingness to reduce the level of generation or increase the level of demand.

Lead Parties of BM Units may also choose to participate in the Replacement Reserve market, i.e. to provide balancing services actions, for a particular Settlement Period. This willingness to operate at a level other than their FPN is demonstrated with the use of Replacement Reserve Bids. Note a Replacement Reserve Bid can indicate either a willingness to increase the level of generation or reduce the level of demand, or a willingness to reduce the level of generation or increase the level of demand.

Virtual Lead Parties, Asset Metering Virtual Lead Parties and Suppliers may take part in both the Balancing Mechanism and the Replacement Reserve markets. Virtual Lead Parties and Asset Metering Virtual Lead Parties will submit bids to provide balancing services actions through the mechanism of Secondary BM Units and Suppliers will do so through Additional BM Units. Virtual Trading Parties will submit Wholesale Market Activity Notifications ) to the ECVAA, will be party to Energy Contract Volume Notifications or Metered Volume Reallocation Notifications1 which reflect the Wholesale volumes traded and will submit MSID Pair Delivered Volumes relating to Wholesale Market Activity through Trading Secondary BM Units. Secondary BM Units, Trading Secondary BM Units and Additional Supplier BM Units will be comprised of MSID Pairs; Secondary BM Units submitted by Asset Metering Virtual Lead Parties may also include AMSID Pairs. A MSID Pair must contain an Import MSID and will usually (but does not have to) contain an Export MSID. Similarly, an AMSID Pair must contain an Import AMSID and will usually (but does not have to) contain an Export AMSID. Virtual Trading Parties and Virtual Lead Parties will submit MSID Pair Delivered volumes and Asset Metering Virtual Lead Parties will submit MSID Pair Delivered volumes or AMSID Pair Delivered volumes to the BSC Central Systems for each accepted Balancing Mechanism Bid/Offer, Replacement Reserve Bid and Wholesale Market Activity.

Suppliers, Virtual Lead Parties and Asset Metering Virtual Lead Parties can opt to set their Additional and Secondary BM Units as a “Baselined BM Unit”. Virtual Trading Parties must set their Trading Secondary BM Units as a “Baselined BM Unit” An FPN is still submitted to National Grid for dispatch purposes, with the exception that Virtual Trading Parties are not required to submit FPNs in respect of Wholesale Market Activities, but the FPN is not used to calculate Non-Delivery Charges. Instead Settlement systems calculate their own FPN-equivalent (the “Settlement Expected Volume”). The Lead Party specifies (when they allocate each MSID Pair or AMSID Pair to the Baselined BM Unit) how that MSID Pair or AMSID Pair’s contribution to the Settlement Expected Volume should be calculated:

1. Baselined MSID Pairs (or AMSID Pairs): SVAA will use historic metered data to calculate the baseline consumption for the MSID Pair or AMSID Pair (in accordance with a Baselining Methodology Document agreed by the BSC Panel);

2. Non-Baselined MSID Pairs (or AMSID Pairs): The Lead Party calculates the FPN-equivalent, and submits a total figure (per BM Unit and Settlement Period) for all the non-Baselined MSID Pairs and AMSID Pairs; or

3. Inactive MSID Pairs (or AMSID Pairs): temporarily excluded from the BM Unit (for Settlement purposes). Secondary BM Units and Trading Secondary BM Units only.

The NETSO takes the submitted FPNs, Bid/Offer data and Replacement Reserve Bids, together with its own forecast of demand and knowledge of system constraints in the relevant Settlement Period and identifies which Bids and/or Offers it needs to accept in order to control the national and local balance of generation and demand. For each Bid-Offer Acceptance (BOA) the NETSO indicates whether the Acceptance was potentially taken to resolve a transmission constraint using a System Operator Flag (SO-Flag). If the BOA was potentially taken to resolve a transmission constraint the SO-Flag is set to TRUE (and is set to FALSE if the NETSO considers the BOA was not taken to resolve a transmission constraint). The SO-Flag is used to determine whether a BOA should retain its price in the calculation of the main Energy Imbalance Price. SO-Flagged BOAs with a price which is more expensive (from the point of view of the System) than the most expensively priced unflagged balancing action are unpriced. BOAs with a less expensive price (from the point of view of the System) than the most expensively priced unflagged action retain their price.

For each Settlement Period the actual volume of energy transferred will be measured for each BM Unit and compared to the expected contracted volume (as notified to the ECVAA) adjusted for any accepted Bids and/or Offers. The resulting energy imbalance will be settled using the relevant cash out price calculated by SAA.

In addition to these payments and charges, there is also an information imbalance charge which is applied to the difference between the metered output of a BM Unit and the level at which a BM Unit was expected to operate given its FPN adjusted for any accepted Offers and Bids.

All Balancing Mechanism and Imbalance Settlement calculations will be performed by the SAA who will then issue information to the FAA detailing the amounts payable to or by Trading Parties with respect to each Settlement Period.

For accepted Secondary BM Unit balancing services actions, Trading Secondary BM Unit Wholesale Market Activity Notifications and for non BM Unit Applicable Balancing Services actions provided to the NETSO outside of the BM, the SVAA will receive MSID Pair Delivered Volume Data or AMSID Pair Delivered Volume Data and will calculate the appropriate corrections to the imbalance position of each Supplier whose (Primary) BM Unit(s) contain MSID(s) that have been used to provide balancing services actions and send these, along with Secondary BM Unit Delivered Volumes and Supplier BM Unit Non BM Unit ABSVD to the SAA for use in Settlement.

Suppliers who operate within Supplier Volume Allocation appoint agents to carry out certain functions required by the Code. These agents include Data Collectors (half hourly and non half hourly) and Data Aggregators (half hourly and non half hourly). SVA Meter Operator Agents are appointed in accordance with the Retail Energy Code Metering Operation Schedule to carry out certain functions as required by the REC. Suppliers register their Agents with the relevant Supplier Meter Registration Service (SMRS).

Asset Metering Virtual Lead Parties and Suppliers appoint Meter Operator Agents or Asset Metering Meter Operator Agents, and Half Hourly Data Collectors and (where appropriate may also appoint Asset Metering Half Hourly Data Collectors) to carry out certain functions relating to SVA Asset Meters registered with the SVAA required by the Code. Asset Metering Virtual Lead Parties and Suppliers register Meter Operator Agents and Half Hourly Data Collectors with the SVAA.

The Data Collectors collect and process meter readings (including data estimation). Settlement of Non Half Hourly Metering Systems is performed on the basis of profiled Annualised Advance (AA) and Estimated Annual Consumption (EAC) values for onward submission to the Non Half Hourly Data Aggregator. Half Hourly Data Collectors pass validated half hourly metered consumption values to the Half Hourly Data Aggregator.

Half Hourly Data Collectors collect and process Asset Meter readings (including data estimation), which they provide directly to the SVAA (and not to the HHDA). Where an Asset Metering Half Hourly Data Collector is also appointed, they shall pass Asset Meter readings to the HHDC to process and provide to the SVAA.

Half Hourly Data Aggregators will send HH Metering System Metered Volume Data to the SVAA for each MSID notified to it by the SVAA, for use in the Secondary BM Units Settlement calculations.

The Data Aggregators aggregate the meter readings (half hourly) or AA and EAC values (non half hourly) received from the Data Collectors according to the registration data held by the SMRA. The Data Aggregators provide the aggregated data to the SVAA.

1.7 Use of the Procedure

1.7.1 Description of Context and Process Diagrams

The Trading Arrangements context diagram shown in section 3.1 shows only the main processes and interfaces between Parties, Party Agents, the ECVAA, BMRA, CDCA, the NETSO, the MIDPs, the Settlement Administration Agent (SAA), the Supplier Volume Allocation Agent (SVAA) and the Funds Administration Agent (FAA).

The Context and Process Diagrams provide a summary of the activities and interactions of the main parties involved in the trading process, shown without timescales and do not cover non-Settlement dependent processes and dataflows. Please note however, whilst a time-line is implied from left to right across the page, the relationship between process schedules may not be accurately reflected here. To ensure as much clarity as possible, some minor dataflows and reports are not shown in the diagrams.

Section 3.2 shows the trading processes prior to Settlement

Section 3.3 illustrates the Interim Information and Initial Volume Allocation / Settlement Runs

Section 3.4 shows the three Reconciliation and Final Reconciliation Volume Allocation / Settlement Run Processes.

1.7.2 Overview of Settlement Timetable

Table 4.1 shows the tasks from Energy Contract Volume and Meter Volume Reallocation Notification through to the Interim Information Volume Allocation Run by the SVAA, the Interim Information Settlement Run by SAA, the Initial Volume Allocation Run by SVAA, the Initial Settlement Run by SAA through to Initial Funds Transfer by FAA.

Table 4.2 details the three Reconciliation Runs through to the Final Reconciliation Settlement Run at 14 months.

Table 4.3 (the annual processes involved in the production of the Payment Calendar and SAA Settlement Calendar) has been transferred to BSCP301.

1.8 Settlement Administration Agent Obligations with regard to input data

In accordance with the Code, the SAA has an obligation to receive and validate input data (described in more detail in the Settlement timetable) from the following Parties and Agents:

National Electricity Transmission System Operator;

Balancing Mechanism Reporting Agent;

Central Data Collection Agent;

Energy Contract Volume Aggregation Agent;

Interconnector Administrators;

Supplier Volume Aggregation Agent;

Central Registration Agent; and

Market Index Data Providers.

The actions to be taken when data is found to be missing or invalid (where not already defined in the Code) for inputs into Settlement are described in Appendices 5.1 and 5.2.

2 Acronyms and Definitions

2.1 Acronyms

A list of acronyms can be found in Annex X of the Code.

The following acronym is used in this Procedure:

T is the Payment Date for all Timetabled Reconciliation Settlement Runs, as set by the Payment Calendar, and expressed in Working Days from the relevant Settlement Day. In order to allow for days when processing does not take place such as Bank Holidays, the value of T will fall within a “window” as defined in 4.2.

2.2 Definitions

A list of definitions can be found in Annex X of the Code. Definitions used in this Procedure (if any) are as follows:

Dynamic Data – Data included in the Dynamic Data Set.

QAS - Applicable Balancing Services Volume

IIR – Interim Information Run

3 Process Diagrams

3.1 Trading Arrangements Context Diagram

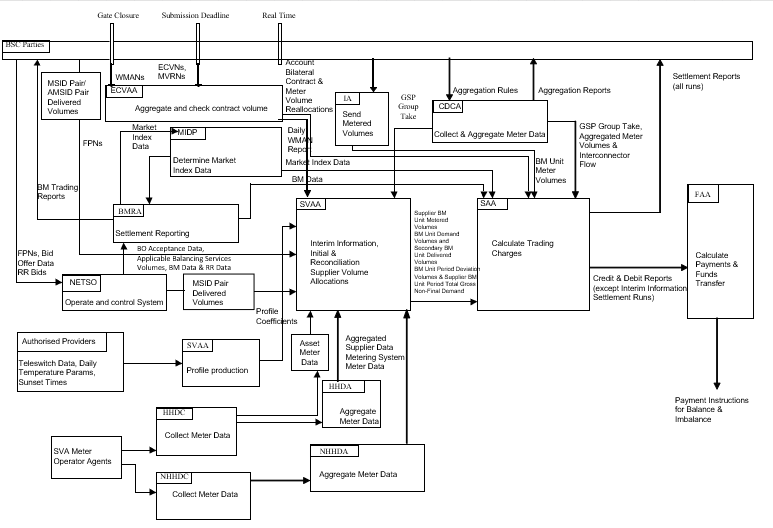

complex image of process

3.2 Trading Processes prior to Settlement

complex image of process

Please note that within this diagram, TC is the equivalent of NETSO.

3.3 Interim Information and Initial Volume Allocationcomplex image of processn / Settlement Runs

3.4 Reconciliation and Final Reconciliation Volume Allocation / Settlement Runs2

complex image of process

3.5 Replacement Reserve Process

complex image of process

4 Interface and Timetable Information

4.1 Interim Information and Initial Settlement Timetable and Settlement Reports

This section covers the tasks required for the Interim Information and Initial Settlement Runs. The Interim Information run is carried out at approximately 5 WD, with no associated Payment Date. The Initial Settlement Run is carried out at approximately 16 WD, with an associated Payment Date of approximately 20 – 21 WD.

Ref

Task

Responsibility

Time-scale

1

Send to ECVAA

Energy Contract Volume Notifications

ECVNA

To be received by ECVAA before the Submission Deadline

2

Send to ECVAA:

Meter Volume Reallocation Notifications

MVRNA

To be received by ECVAA before the Submission Deadline

2A

Send to ECVAA:

Wholesale Market Activity Notifications

VTP

To be received by ECVAA before Gate Closure

3

Send the following information (for each BM Unit in respect of which the Lead Party is obliged to submit a FPN or has chosen to submit a FPN) to the NETSO:

Final Physical Notification Data

Bid / Offer Data (Required only if trading in Balancing Mechanism)

Dynamic Data

Lead Parties

To be received by the NETSO before Gate Closure

4

Send to SVAA for each Baselined BM Unit, and for MSID Pairs or AMSID Pairs which are not Baselined or Inactive:

Submitted Expected Volumes

Lead Parties

To be received by SVAA before Gate closure for a Settlement Period

5

Send to BMRA:

Market Index Data

Market Index Data Providers

Target by end of Settlement Period

6

Accept Bids and Offers as required to meet forecast and actual system conditions. Acceptances which are taken to resolve transmission constraints are SO-Flagged.

NETSO

Not later than 15 minutes following the issue of an Acceptance; or

In the case of an Emergency Instruction, as soon as reasonably practicable.

7

Energy Transfer and Metering

Lead Parties

Settlement Period

8

Send the following information to BMRA (for information / storage) for each BM Unit in respect of which the Lead Party is obliged to submit a FPN or has chosen to submit a FPN to the NETSO:

Maximum Export Limit

Maximum Import Limit

Final Physical Notification Data

Dynamic Data

Bid Offer Data (for those BM Units for which such data has been provided)

Acceptance Data

System related Data

BM Unit Applicable Balancing Services Volume Data

Replacement Reserve Data

NETSO

Target Times:

Not later than 5 minutes following receipt

Not later than 15 minutes following Gate closure for each Settlement Period

Not later than 1200 hrs each day

9

Send Final Physical Notification Data to ECVAA.

Calculate Indicative System Buy Price and Indicative System Sell Price and publish relevant data

BMRA

Upon receipt from the NETSO.

15 + CADL minutes after end of Settlement Period.

10

Send the following information to SAA to enable Settlement:

Final Physical Notification Data

Balancing Services Adjustment Data

Bid Offer Data

Acceptance Data

Any Dynamic Data received by the NETSO during the Settlement Day

BM Unit Applicable Balancing Services Volume Data

BMRA

The next day following the Settlement Day for Balancing Services Adjustment Data, and by 15 minutes following the end of the Settlement Day for the other items.

Within 2 Business Days following the relevant Settlement Period for BM Unit Applicable Balancing Services Volume Data

11

Interrogate Metering Systems registered by Parties with the CRA and collect consumption data.

Send to relevant Parties:

Raw Meter Data together with any validation criteria

CDCA

Send out by Settlement Day +1 (1300hrs)

12

Send to SVAA:

Tele-switch data

Tele-switch Agent

By +1 WD (by 1000hrs)

13

Obtain the following data from relevant authorised providers:

Daily temperature parameters by GSP Group

Sunset times by GSP Group (annually)

Perform Profile Production Run

Send Profile Reports to Suppliers and NHHDCs

SVAA

By +1 WD (by 1000hrs)

By +1 WD (by 1700hrs)

14

Send to SAA:

BM Unit Metered Volumes for the BM Units of each Interconnector User for each Interconnector

IA

By +1 WD

15

Send to SAA:

Market Index Data

Market Index Data Providers

By +1 WD

16

Send to SVAA

MSID Pair Delivered Volumes for

procured balancing services

or

Wholesale Market Activities

VLP

or

VTP

By +1 WD (by 1700hrs)

MSID Pair Delivered Volumes or AMSID Pair Delivered Volumes for procured balancing services

AMVLP

Wholesale Market Activity Notification Report

ECVAA

17

Suppliers raise query on Daily Profile Production Reports if necessary and log with Dispute Administrator

Supplier

By +3 WD (by 1000hrs)

18

Resolve Daily Profile Production query

SVAA

By +4 WD (by 1300hrs)

19

Amend Profile variables ready to re-run Daily Profile Production, if necessary

SVAA

By +4 WD (by 1500hrs)

20

If re-run of Daily Profile Production required then carry this out and send revised Daily Profile Production Reports to relevant Suppliers

SVAA

By +4 WD (by 1730hrs)

21

Collate information for use in the Interim Information Run

Send to SAA:

Meter Volume Reallocation Notification, by BM Unit for each Settlement Period

Account Bilateral Contract Volumes for each Settlement Period by BSC Party

ECVAA

In accordance with SAA Settlement Calendar

22

Carry out CDCA Aggregation for Interim Information Volume Allocation Run using the latest available data, i.e. valid actual meter data and/or agreed estimated meter data (for all missing or invalid readings) and the latest available approved Line Loss Factors, Aggregation Rules, Registration Data and Meter Technical Details.

Send to SAA:

BM Unit Metered Volumes for each BM Unit

GSP Group Take

Interconnector Metered Volumes

Send to SVAA:

GSP Group Take

Send to BSC Parties:

GSP Group Take

Send to Lead Party and NETSO

BM Unit Aggregation Report

CDCA

By + 4 WD (0900hrs)

23

Ensure Agents send to SVAA:

Half Hourly Aggregation Files from HHDAs

Half Hourly Metering System Metered Volumes from HHDAs

Supplier Purchase Matrices from NHHDAs

Suppliers

By +4 WD (0900hrs)

24

Carry out Interim Information Volume Allocation Run

Calculate the Supplier Volume Allocations for each BM Unit

Calculate the Supplier BM Unit Period Total Gross Non-Final Demand for each BM Unit

Calculate the BM Unit Period Deviation Volume for each BM Unit

SVAA

By +4 WD (from 0900hrs)

25

Send to SAA:

BM Unit Metered volumes for Supplier BM Units

Secondary BM Units Demand Volumes

Secondary BM Unit Delivered Volumes

Supplier BM Unit Non-Chargeable Demand

Supplier BM Unit Period Total Gross Non-Final Demand

BM Unit Period Deviation Volume

SVAA

For receipt by + 5 WD (0900hrs)

26

Send Interim Information Volume Allocation Run Reports to relevant Suppliers

SVAA

By +5 WD

27

Carry out Interim Information Settlement Run using data from CDCA, ECVAA, SVAA, NETSO and MIDPs and send relevant reports to Parties.

Issue IIR Credits/Debits Report to ECVAA.

Issue BM Unit Non-Chargeable Demand Report to the EMR Settlement Company. Publish TLM-Adjusted Non-Chargeable Demand Report on Elexon Portal.

SAA

By + 5 WD or later if delayed in accordance with the Code

28

Implement SVAA resolution on profile query or request arbitration from Disputes Administrator

Supplier

By + 5 WD (by 1600hrs)

29

Communicate outcome of arbitration to affected Suppliers and SVAA

Dispute Administrator

By +7 WD (by 1000hrs)

30

If arbitration against SVAA, amend profile variables ready to re-run Daily Profile Production

SVAA

By +7 WD (by 1430hrs)

31

Implement results from arbitration and send revised profiles to affected Suppliers

SVAA

By +7 WD (by 1800hrs)

32

Send MSID Pair Delivered Volumes to SVAA

NETSO

By +11 WD3

33

Estimate volumes for missing or disputed data in accordance with the Code.

Carry out CDCA Aggregation for Initial Volume Allocation Run using the latest available data i.e. valid actual meter readings and/or any agreed estimates and the latest available approved Line Loss Factors, Aggregation Rules, Registration Data and Meter Technical Details.

Send to Parties:

GSP Group Take

Send to Lead Party and NETSO

BM Unit Aggregation Report

Send to SVAA:

GSP Group Take

Send to SAA:

CDCA Aggregation File

CDCA

For receipt by +14 WD

34

Ensure Agents send to SVAA:

Half Hourly Aggregation Files from HHDAs

Half Hourly Metering System Metered Volumes from HHDAs

Supplier Purchase Matrices from NHHDAs

Half Hourly Asset Metering System Metered Volumes from HHDCs

Suppliers

AMVLPs

By +14 WD

35

Carry out Initial Volume Allocation Run

Calculate the Supplier Volume Allocations for each BM Unit

SVAA

By +15 WD (from 0900hrs)

36

Send to SAA:

BM Unit Metered volumes for Supplier BM Units

Secondary BM Units Demand Volumes

Secondary BM Unit Delivered Volumes

Supplier BM Unit Non BMU ABSVD Volume4

Supplier BM Unit Period Total Gross Non-Final Demand

BM Unit Period Deviation Volume

SVAA

For receipt by + 16 WD (0900hrs)

37

Send:

Relevant Reports to NETSO

DUoS Report to Distribution Businesses

Initial Volume Allocation Run Reports to Suppliers

SVAA

By + 16 WD (before 1230hrs)

)

)By + 17 WD

)

37

Carry out Initial Settlement Run using latest files from NETSO, ECVAA, CDCA and SVAA and MIDPs; and send relevant reports to BSC Parties.

Send Settlement Report to FAA

SAA

By +16 WD

(subject to SAA Settlement Calendar) or later if delayed in accordance with the Code

For receipt by + 17 WD (0900hrs)

(subject to Payment Calendar)

38

Receive Settlement Report from SAA

Calculate Payments

FAA

By +17–18 WD

(subject to Payment Calendar)

39

Send Advice Notes to Payment Parties

FAA

By +17–18 WD

(subject to Payment Calendar)

40

Funds transfers between Parties’ Banks

FAA

By +20–21 WD

(subject to Payment Calendar)

4.2 Reconciliation Timetable and Settlement Reports

This section covers all Timetabled Volume Allocation Runs and all Timetabled Reconciliation Settlement Runs. The tasks required for the Interim Information and Initial Settlement Runs are defined in Section 4.1.

The following tasks are repeated at:

T = approximately 39 WD (between 36 and 40 WD) for the 1st Reconciliation Settlement Run;

T = approximately 84 WD (between 81 and 85 WD) for the 2nd Reconciliation Settlement Run;

T = approximately 154 WD (between 151 and 155 WD) for the 3rd Reconciliation Settlement Run; and

T = approximately 292 WD (between 289 and 293 WD) for the Final Reconciliation Settlement Run.

T is the Payment Date, expressed by reference to the Settlement Day.

In each case, the first figure reflects the target to be used in preparing the Payment Calendar, and all dates must be within the range specified in brackets. Precise timings for Reconciliation Settlement Runs and are governed by the Payment Calendar and/or SAA Settlement Calendar for the relevant period.

It should be noted that all tasks relating to all Timetabled Volume Allocation Runs and all Timetabled Reconciliation Settlement Runs may also be repeated in support of a Post Final Settlement Run up to and including 28 months after the Settlement Day5

Ref

Task

Responsibility

Time-scale (*)

1

Ensure Agents send to SVAA:

Revised Half Hourly Aggregation Files from HHDAs

Half Hourly Metering System Metered Volumes from HHDAs

Revised Supplier Purchase Matrices from NHHDAs

Suppliers

By T – 6 WD

Note: Dependent on SVAA Calendar

2

Estimate volumes for missing or disputed data in accordance with the Code.

Re-run Aggregation Process using the latest available data i.e. valid actual meter data and/or any agreed estimates and the latest approved Line Loss Factors, Aggregation Rules, Registration Data and Meter Technical Details applicable for the relevant Settlement Day.

Send to Parties:

CDCA Aggregation Reports

Send to SVAA:

GSP Group Take

Send to SAA:

CDCA Aggregation File

CDCA

By T – 6 WD

Note: Dependent on SAA Settlement Calendar

3

Carry out Reconciliation Volume Allocation Run

Calculate the Supplier Volume Allocation for each BM Unit.

SVAA

By T – 5 WDNote: Dependent on SVAA Calendar

4

Send to SAA

BM Unit Metered Volumes for Supplier BM Units

Secondary BM Units Demand Volumes

Secondary BM Unit Delivered Volumes

Supplier BM Unit Non BMU ABSVD Volume

Supplier BM Unit Non-Chargeable Demand

SVAA

For receipt by T – 4 WD (0900hrs)

Note: Dependent on SVAA Calendar

5

Send:

Relevant Reports to NETSO

Updated DUoS Report to Distribution Businesses

Reconciliation Volume Allocation Run Reports to Suppliers

SVAA

By T – 4 WD (before 1230hrs)

)

) By T – 3 WD

)

6 *

Carry out Reconciliation Settlement Run using latest available files from NETSO, ECVAA, CDCA and SVAA and MIDP

Send to FAA

Reconciliation Settlement Report

Send to BSC Parties:

Reports on financial position

Send to EMR Settlement Company

BM Unit Non-Chargeable Demand Report

SAA

By T – 4 WD

For receipt by T – 3 (0900hrs)

7

Receive Reconciliation Settlement Report from SAA (Notification Date)

Calculate Payments

FAA

By T – 3 WD

8

Send to Parties

Advice Notes

FAA

By T – 3 WD

9

Authorise the financial transfers between Parties’ Banks (Payment Date)

FAA

By T

10

Send MSID Pair Delivered Volumes to SVAA

NETSO

No later than SD + 45 calendar days6

(*) Precise timings are governed by the Payment Calendar and/or SAA Settlement Calendar and/or SVAA Calendar.

4.3 Produce Payment Calendar and SAA Settlement Calendar (transferred to BSCP301)

Note: this has been amended to include both FAA and SAA obligations and has been transferred to BSCP301 (Clearing, Invoicing and Payment).

5 Appendices

5.1 Interim Information Settlement Run

If the SAA detects invalid or missing data in respect of the relevant Settlement Day prior to carrying out the relevant Settlement Run for the following data items:

Final Physical Notification Data (from BMRA/NETSO)

Balancing Services Adjustment Data (from BMRA/NETSO)

Bid Offer Data (from BMRA/NETSO)

Acceptance Data (from BMRA/NETSO)

BM Unit Applicable Balancing Services Volume Data (from BMRA/NETSO)

BM Unit Metered Volumes for Interconnector BM Units (from IA)

BM Unit Metered Volumes for BM Units other than Supplier BM Units and Interconnector BM Units (from CDCA)

Metered Volume Reallocations by BM Unit (from ECVAA)

Account Bilateral Contract Volumes (from ECVAA)

GSP Group Take for each GSP Group (from CDCA)

Interconnector Metered Volumes (from CDCA); and

Market Index Data (from MIDP)

BM Unit Metered Volumes for Supplier BM Units (from SVAA)

Secondary BM Units Demand Volumes and Secondary BM Unit Delivered Volumes (from SVAA)

BM Unit Period Non-Chargeable Demand (from SVAA)

Supplier BM Unit Period Total Gross Non-Final Demand and BM Unit Period Deviation Volume (from SVAA)

Then the SAA shall inform BSCCo and proceed in accordance with BSCCo instruction.

In the event that the SAA receives invalid or missing data and is required to consult with BSCCo, the decision on whether and what default data should be substituted shall be at the absolute discretion of BSCCo.

When incomplete data is submitted for an Interim Information Settlement Run, section T1.4.2 of the BSC states that the SAA should form an opinion on whether the proportion of data missing is 'significant', and whether the missing data is likely to be received by the end of the next Business Day, before seeking instructions from BSCCo. In practice, however, both BSCCo and the SAA prefer that BSCCo should take the lead in reaching decisions on these issues. For this reason, the SAA informs BSCCo of missing or invalid data in all cases.

5.2 Initial Settlement Run

If the SAA does not expect to receive substantially complete and valid data in respect of the relevant Settlement Day in time to carry out the relevant Settlement Run for the following data items:

Final Physical Notification Data

Balancing Services Adjustment Data

Bid Offer Data

Acceptance Data

BM Unit Applicable Balancing Services Volume Data

BM Unit Metered Volumes for Interconnector BM Units (from IA)

BM Unit Metered Volumes for Supplier BM Units (from SVAA)

Secondary BM Units Demand Volumes and Secondary BM Unit Delivered Volumes (from SVAA)

Supplier BM Unit Period Total Gross Non-Final Demand and BM Unit Period Deviation Volume (from SVAA)

BM Unit Metered Volumes for BM Units other than Supplier BM Units and Interconnector BM Units (from CDCA)

Metered Volume Reallocations;

Account Bilateral Contract Volumes;

GSP Group Take for each GSP Group;

Interconnector Metered Volumes; and

Market Index Data

The SAA shall consult BSCCo and proceed in accordance with the BSC under BSCCo instruction. The decision by BSCCo on whether and what default data should be substituted shall be at the absolute discretion of BSCCo.

When incomplete data is submitted for an Initial Settlement Run, Section T1.4.5 of the BSC states that the SAA should form an opinion on whether the data is 'substantially complete' before seeking instructions from BSCCo. In practice, however, both BSCCo and the SAA prefer that BSCCo should take the lead in reaching decisions on these issues. For this reason, the SAA will inform BSCCo of missing or invalid data in all cases.

AMENDMENT RECORD

Version

Date

Description of Changes

Changes Included

Mods/ Panel/

Committee Refs

1.0

08/08/2000

Go Active version

n/a

n/a

2.0

30/11/00

Work Outstanding at Go Active, resolution of inconsistencies, inclusion of consultation comments.

242,191,216

08/009

3.0

13/8/02

Change Proposals and Code Modifications for BSC Systems Release 2

CP563, CP572, CP630; P18A, P49

ISG/1

4.0

30/9/02

Code Modification P2

P2

ISG16/166

SVG17/208

5.0

27/08/02

Phase 2A (Dec 02) Release – Draft

CP629, CP639

ISG15/151

ISG11/093

6.0

25/02/03

February 03 Release

P71, P78

ISG 24/265

SVG24/311

7.0

24/06/03

June 03 Release

CP736

ISG17/177

8.0

04/11/03

November 03 Release

P107, P82

59/009

54/006

9.0

30/06/04

CVA Programme June 04 Release

CP945

CP854, CP971

P82 Removal

ISG40/003

10.0

03/11/04

CVA Programme Nov 04 Release

CP1032

TDC58/03

11.0

23/02/05

CVA Programme Feb 05 Release

CP1091

BETTA 6.3

P140

12.0

26/06/08

June 08 Release

CP1223

SVG84/02

ISG84/01

TDC109/01

PAB84/11

13.0

05/11/09

November 09 Release

P217

Panel 142/06

14.0

03/11/11

November 11 Release

P253

ISG127/02

SVG127/13

15.0

25/06/15

June 15 Release

CP1426

ISG166/06, SVG169/05

16.0

29/06/17

June 17 Release

P350

ISG194/02

SVG196/03

17.0

02/11/17

November 17 Release

P342 Alternative

ISG198/04

SVG200/03

18.0

29/03/19

29 March 19 Standalone Release

P369

P285/12

19.0

11/12/19

11 December 2019 Standalone Release

CP1517

ISG220/01, SVG223/03

20.0

27/02/2020

27 February 2020 Release

P394 Self-Governance

P297/07

21.0

01/04/2020

1 April 2020 Standalone Release

P354, P388

ISG227/04,

SVG 229/07

22.0

01/09/2021

1 September 2021 Non-Standard Release

P420

P316/05

23.0

30/06/2022

30 June 2022 Standard Release

P375, P433

P309/06, P322/05

24.0

23/02/2023

23 February 2022 Standard Release

P376

P314/06

25.0

02/11/2023

02 November 2023 Standard Release

P395

P340/05

26.0

07/11/2024

07 November 2024 Standard Release

P415

P339/03

1Virtual Trading Parties may not use Secondary BM Units in MVRNs.

2 Where an upheld Trading Dispute is to be processed after the Final Reconciliation Settlement Run has been performed then a Post-Final Settlement Run or Extra-Settlement Determination may be required as described in BSCP11.

3 Where such data is available to the NETSO

4 Relating to the MSID Pair Delivered Volumes received by the SVAA

5 Note that that Post-Final Settlement or Volume Allocation Runs may be requested after 28 months, but only for the purposes of the Rectification of Past Notification Error

6 Where such data has not been supplied already under Section 4.1.31
